SWPPP inspection form

A site inspection form for qualified SWPPP inspectors on construction sites covered by the EPA 2022 Construction General Permit or a similar state permit. It follows Parts 4 and 5 of the CGP, control by control, and marks each one OK, routine maintenance or corrective action.

Add your email to download. It goes to the Inspectial team, not a mailing list (privacy).

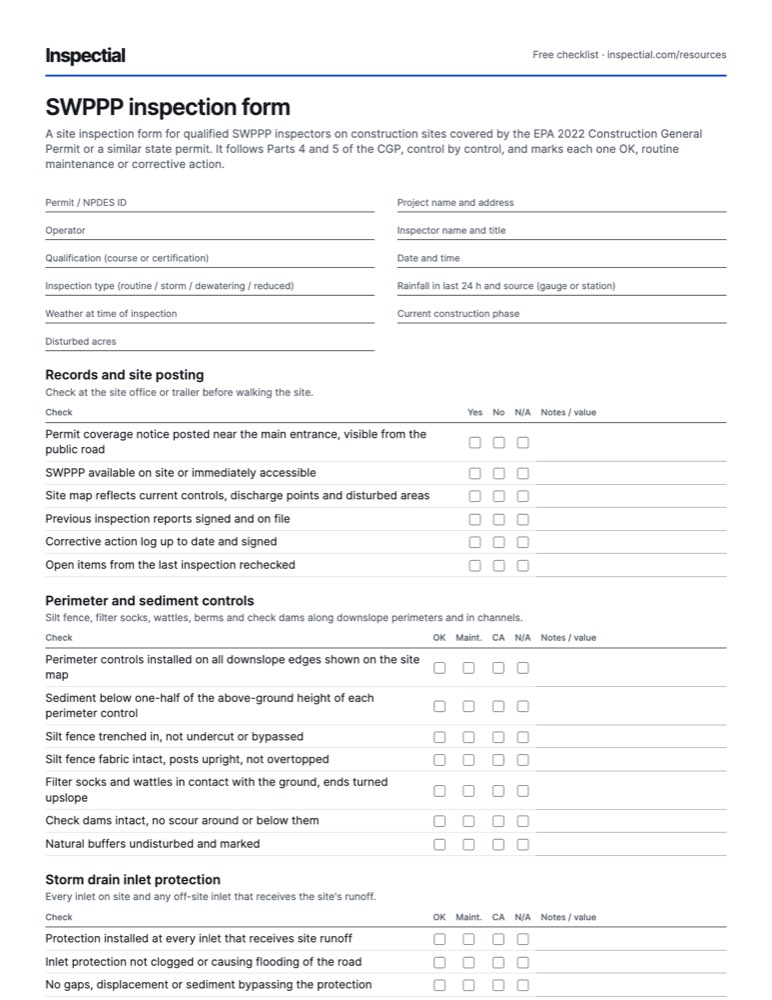

First page of the free SWPPP inspection form PDF

What is a SWPPP inspection form?

A SWPPP inspection form is the report a qualified inspector completes on a permitted construction site to show that erosion, sediment and pollution prevention controls are installed, working and maintained. It records the inspection date and trigger, findings for each control, any discharges, and the routine maintenance or corrective actions needed, and must be signed.

When to inspect

Under Part 4.2 of the EPA 2022 CGP, inspect at least once every 7 calendar days, or once every 14 calendar days plus within 24 hours of a storm producing 0.25 in of rain in 24 hours (or a snowmelt discharge from 3.25 in of snow). Sites discharging to sediment- or nutrient-impaired or Tier 2, 2.5 or 3 waters must do both (Part 4.3). Complete the report within 24 hours of the inspection (Part 4.7.1). State permits differ: California requires weekly inspections plus pre-, during- and post-event inspections for qualifying rain.

The checklist

Every row is one observable check. Mark one answer per row and write what you saw or measured; the PDF adds a findings table and sign-off.

Header

Permit / NPDES ID
Project name and address
Operator
Inspector name and title
Qualification (course or certification)
Date and time
Inspection type (routine / storm / dewatering / reduced)
Rainfall in last 24 h and source (gauge or station)
Weather at time of inspection
Current construction phase
Disturbed acres

Records and site posting

Check at the site office or trailer before walking the site.

CheckYesNoN/ANotes / value
Permit coverage notice posted near the main entrance, visible from the public road
SWPPP available on site or immediately accessible
Site map reflects current controls, discharge points and disturbed areas
Previous inspection reports signed and on file
Corrective action log up to date and signed
Open items from the last inspection rechecked

Perimeter and sediment controls

Silt fence, filter socks, wattles, berms and check dams along downslope perimeters and in channels.

CheckOKMaint.CAN/ANotes / value
Perimeter controls installed on all downslope edges shown on the site map
Sediment below one-half of the above-ground height of each perimeter control
Silt fence trenched in, not undercut or bypassed
Silt fence fabric intact, posts upright, not overtopped
Filter socks and wattles in contact with the ground, ends turned upslope
Check dams intact, no scour around or below them
Natural buffers undisturbed and marked

Storm drain inlet protection

Every inlet on site and any off-site inlet that receives the site's runoff.

CheckOKMaint.CAN/ANotes / value
Protection installed at every inlet that receives site runoff
Inlet protection not clogged or causing flooding of the road
No gaps, displacement or sediment bypassing the protection
Sediment removed from around the inlet

Construction exits and track-out

CheckOKMaint.CAN/ANotes / value
Vehicles leaving only at designated, stabilized exits
Exit stone or mats in place and not clogged with sediment
No sediment tracked onto paved roads or sidewalks
Track-out removed by sweeping or vacuuming, not hosed into drains

Stabilization and slopes

Stabilization must begin immediately where work has stopped for 14 or more days (CGP Part 2.2.14).

CheckOKMaint.CAN/ANotes / value
Inactive areas stabilized or stabilization started on time
No rills or gullies on slopes or exposed soil
Erosion control blankets and matting in place and anchored
Seeded areas showing vegetation, no washouts
Stockpiles covered or stabilized, with a sediment barrier downslope
Dust controlled on exposed soil and haul roads
Diversions and swales stable, not eroding

Sediment basins, traps and dewatering

Dewatering discharges need their own inspection record (CGP Part 4.6.3).

CheckOKMaint.CAN/ANotes / value
Sediment basin at or above one-half of design capacity
Basin outlet and skimmer working, not clogged
Basin embankment and spillway stable, no erosion or seepage
Dewatering water routed through a treatment control before discharge
Dewatering discharge free of a sediment plume, sheen or foam
Treatment chemicals stored and used as the SWPPP describes

Pollution prevention and materials

CheckOKMaint.CAN/ANotes / value
Concrete washout in use, not full and not leaking
No concrete, paint or stucco washwater on bare ground or in drains
Fuel and chemicals stored with secondary containment or cover
Fueling and maintenance areas free of leaks and stained soil
Spill kit present and stocked
Dumpsters covered or lidded, not leaking
Portable toilets secured so they cannot be tipped over
Building materials stored to prevent contact with stormwater

Discharge points and receiving waters

Answer for every discharge point on the site map. A yes in the last five rows needs corrective action.

CheckYesNoN/ANotes / value
All discharge points inspected
Discharge occurring at the time of inspection
Sediment deposits or sand bars visible below discharge points
Turbid, discolored or foamy water at a discharge point
Oil sheen or odor at a discharge point
Floating or settled solids in the receiving water
Sediment on streets, curbs or off-site channels attributable to the site

Follow-up and signature

CheckYesNoN/ANotes / value
Routine maintenance items listed with location and due date
Corrective actions entered in the log within 24 hours
Same control repaired 3 or more times flagged as corrective action
Locations where new or modified controls are needed recorded
Areas unsafe to inspect described with the reason
SWPPP and site map changes noted for update
Report signed by the operator's signatory

BMP result codes

OK
Installed, operational and working as intended.
Maint.
Routine maintenance: remove sediment, re-stake, clean or patch. EPA CGP Part 2.1.4 expects it done by the close of the next business day, or within 7 calendar days if that is infeasible.
CA
Corrective action: significant repair, a new or replacement control, a control never installed or installed wrong, or the same fix needed 3 or more times. Log within 24 hours and complete within 7 calendar days (CGP Part 5).
N/A
The control is not on site or not required at this phase. Say why in the notes.

Photos to take

  1. Permit sign at the entrance
  2. Each construction exit and the adjoining paved road
  3. Each inlet protection device
  4. Perimeter controls at the lowest point of each drainage area
  5. Every control marked maintenance or corrective action, before the fix
  6. Each discharge point, and the receiving water if flowing
  7. Stabilized areas, dated, for the Notice of Termination record
  8. Dewatering water before and after treatment, the control and the discharge point

Field tips

  • Write each finding with a location the crew can find again: station, grid or a map ID, not just "east side".
  • Record the rain gauge or weather station reading for every storm-triggered inspection; the report must include it.
  • Count repeats. The third time the same control at the same spot needs the same fix, it becomes a corrective action under CGP Part 5.1.1.
  • Inspect off-site inlets and the street at the exit too; sediment that left the site is what regulators and neighbors notice.
  • Take the follow-up photo after the repair; a before photo alone does not show the corrective action was completed.
  • Check your state permit: many states run their own CGP with different triggers, forms and inspector credentials.

Standards and sources

Checked against these sources on . Your agency's own manual takes precedence.

Questions

How often do SWPPP inspections need to be done?

Under the EPA 2022 CGP, at least once every 7 calendar days, or once every 14 days plus within 24 hours of 0.25 in of rain. Sites draining to impaired or high-quality waters must do both. Stabilized, arid or frozen sites can qualify for reduced frequency, as low as monthly.

Who can perform a SWPPP inspection?

The EPA CGP requires a qualified person who has completed the EPA construction inspection training and exam, or holds a current certification covering the same material. Common certifications include CESSWI and CPESC. States set their own rules, such as QSP and QSD in California.

What must a SWPPP inspection report include?

Under CGP Part 4.7.1: the inspection date, the names and titles of the inspectors, a summary of findings including any routine maintenance or corrective action needed, the rain or snow data for storm-triggered inspections, and any areas unsafe to inspect. It must be completed within 24 hours and signed.

What is the difference between routine maintenance and corrective action?

Routine maintenance keeps a working control effective, such as removing sediment, and is due by the close of the next business day. Corrective action covers significant repairs, missing or wrongly installed controls, permit violations, and any routine fix needed 3 or more times. It must be logged within 24 hours and generally completed within 7 calendar days.

How long do I keep SWPPP inspection reports?

The EPA CGP requires you to keep inspection reports and the corrective action log for at least 3 years after permit coverage expires or is terminated. Reports must be available on site or easily accessible, and electronic records are allowed if they are as readable and dependable as paper.

Do I need photos in a SWPPP inspection?

The EPA CGP requires photos for dewatering inspections and dated photos of stabilized areas with the Notice of Termination. California requires photographs at every weekly inspection. Even where not required, photos of each deficient control before and after the fix are the easiest proof of compliance.

Do this inspection on your phone: AI drafts it, you approve

Inspectial turns the photos, voice notes and GPS from this checklist into a structured, map-ready inspection record. Every finding links to its photo, and nothing is official until you approve it.

A muddy construction site. A black silt fence on wooden stakes runs across the middle, with a soil stockpile, a skid steer and a backhoe behind it. In front, a black filter sock lies kinked on bare soil beside metal posts, and a shallow pool of muddy water stands on the right.
Site S-012730.5127, -97.6842 · SWPPP pack
  • Stockpile · coveruncoveredAI suggested
  • Silt fence · conditionfabric intact, posts uprightHuman verified
  • Silt fence · sedimentbelow ½ fence heightHuman verified
