Pre-construction condition survey checklist

For engineers and surveyors recording the existing condition of neighboring buildings before excavation, piling, blasting or demolition. It covers the building record, every elevation and room, crack mapping with a width gauge, the photo and video protocol and owner sign-off.

Add your email to download. It goes to the Inspectial team, not a mailing list (privacy).

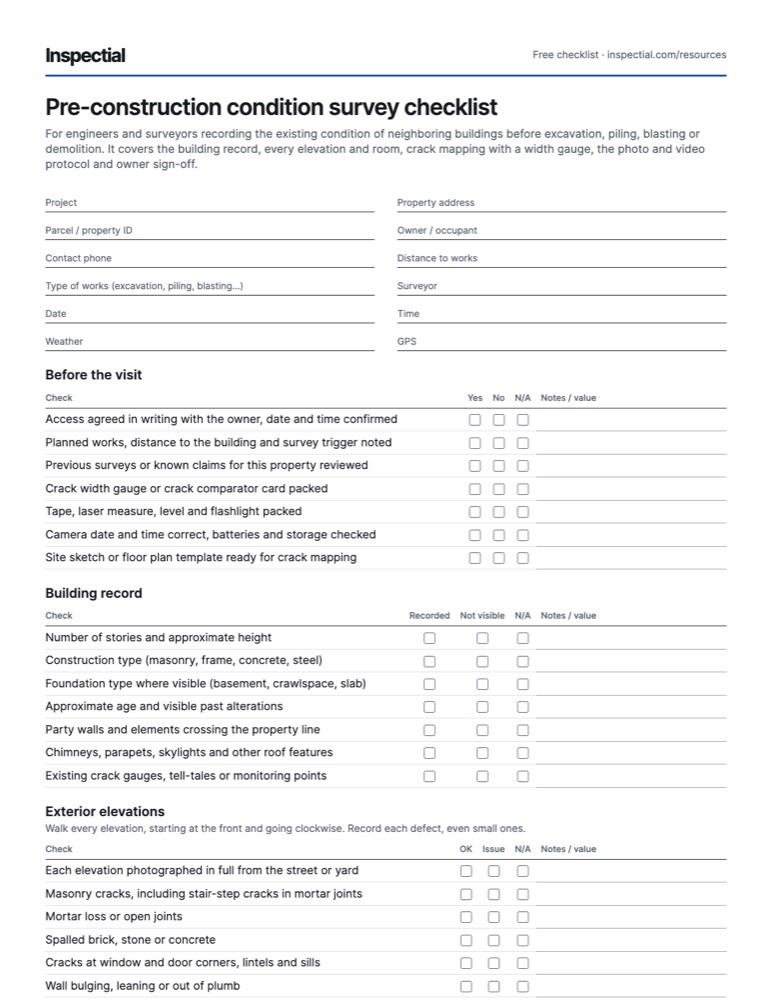

First page of the free Pre-construction condition survey checklist PDF

What is a pre-construction survey checklist?

A pre-construction survey is a documented baseline of the condition of buildings and structures near a construction site, recorded before work that could cause vibration or ground movement. It logs every existing crack and defect by location, type and measured size, with photos and video, so later damage claims can be checked against it.

When to inspect

Once, before work starts, then repeated as a post-construction survey when the work ends or a claim arrives. Philadelphia Code §4-A-3307 requires a survey by a licensed PE when, for example, excavation goes more than 5 ft below adjacent grade within 10 ft of a building. For surface coal mining, 30 CFR 816.62 gives owners within 1/2 mile the right to request a preblasting survey. Elsewhere it is set by contract, permit conditions or the contractor's insurer.

The checklist

Every row is one observable check. Mark one answer per row and write what you saw or measured; the PDF adds a findings table and sign-off.

Header

Project
Property address
Parcel / property ID
Owner / occupant
Contact phone
Distance to works
Type of works (excavation, piling, blasting…)
Surveyor
Date
Time
Weather
GPS

Before the visit

CheckYesNoN/ANotes / value
Access agreed in writing with the owner, date and time confirmed
Planned works, distance to the building and survey trigger noted
Previous surveys or known claims for this property reviewed
Crack width gauge or crack comparator card packed
Tape, laser measure, level and flashlight packed
Camera date and time correct, batteries and storage checked
Site sketch or floor plan template ready for crack mapping

Building record

CheckRecordedNot visibleN/ANotes / value
Number of stories and approximate height
Construction type (masonry, frame, concrete, steel)
Foundation type where visible (basement, crawlspace, slab)
Approximate age and visible past alterations
Party walls and elements crossing the property line
Chimneys, parapets, skylights and other roof features
Existing crack gauges, tell-tales or monitoring points

Exterior elevations

Walk every elevation, starting at the front and going clockwise. Record each defect, even small ones.

CheckOKIssueN/ANotes / value
Each elevation photographed in full from the street or yard
Masonry cracks, including stair-step cracks in mortar joints
Mortar loss or open joints
Spalled brick, stone or concrete
Cracks at window and door corners, lintels and sills
Wall bulging, leaning or out of plumb
Foundation wall cracks above grade
Gutters, downspouts and visible roof condition
Sidewalk, steps and driveway cracks or displacement
Retaining walls, garden walls and fences
Pools, patios and outbuildings
Visible utilities: meters, wells, septic covers, cleanouts

Interior, room by room

In each room record walls, ceiling, floor, doors and windows in a fixed order, so the post-construction survey can follow it.

CheckOKIssueN/ANotes / value
Room photographed: each wall, ceiling and floor
Plaster or drywall cracks on walls
Ceiling cracks
Nail pops and drywall joint cracks
Plaster loss or delamination
Water stains and signs of active leaks
Floor cracks, cracked tiles or uneven floors
Doors that stick, rub or don't latch
Windows that stick, with cracked glass or gaps at the frame
Basement or crawlspace walls: cracks, efflorescence, seepage
Basement slab cracks
Existing repairs, patches or fresh paint over cracks

Crack mapping and measurement

Every crack gets one entry. Width comes from a gauge, never estimated from a photo.

CheckDoneNot doneN/ANotes / value
Crack given a unique ID and marked on the sketch or plan
Location recorded: room or elevation, wall, height and distance from a corner
Orientation recorded: horizontal, vertical, diagonal or stair-step
Length measured
Width measured with the gauge at the widest point
Close-up photo taken with the gauge or a scale in frame
Wide photo taken showing where the crack is on the wall
Tell-tale installed where agreed, with ID and baseline reading

Photo and video protocol

CheckYesNoNotes / value
Every photo time-stamped and geotagged
Narrated video walkthrough of every room and elevation
Photo log links each photo to its room, wall and crack ID
Rooms not accessed listed with the reason
Files copied off the device before leaving site

Owner sign-off

CheckYesNoN/ANotes / value
Owner or occupant present during the survey
Owner shown the main existing defects
Rooms or areas refused by the owner recorded
Owner and surveyor signatures with date
Copy of the report delivered to the owner before works start

Crack width categories (BRE Digest 251)

0 Negligible
Hairline cracks under 0.1 mm.
1 Very slight
Fine cracks up to 1 mm, easily treated during normal decoration.
2 Slight
Cracks up to 5 mm, easily filled. Doors and windows may stick slightly.
3 Moderate
Cracks 5 to 15 mm, or several up to 3 mm. Needs opening up and repair by a mason.
4 Severe
Cracks 15 to 25 mm, also depending on number. Extensive repair; walls may lean or bulge.
5 Very severe
Cracks over 25 mm. Major repair; beams lose bearing, walls lean badly, risk of instability.

Photos to take

  1. Each full elevation from the street or yard, with the house number visible on the front
  2. Each room from the doorway, then each wall, the ceiling and the floor
  3. Wide shot of every crack showing its position on the wall
  4. Close-up of every crack with the width gauge or a scale readable in frame
  5. Doors and windows that stick or show gaps, in the closed position
  6. Water stains, past repairs and existing monitoring devices
  7. Sidewalk, driveway, retaining walls and other site features
  8. A narrated video walkthrough of the whole property

Field tips

  • Measure, don't estimate. A crack recorded as 'hairline' with no width reading is hard to compare against later.
  • Work in a fixed order in every room (for example the entry wall, then clockwise, then ceiling and floor) so the post-construction survey can follow the same route.
  • Record what you can't see. Furniture against a wall, locked rooms and stored goods are part of the baseline too.
  • Photograph small defects as well as big ones. Disputes are usually about the cracks nobody thought were worth recording.
  • Describe, don't diagnose. Note location, type and size; leave the cause of an existing crack to the engineer's report.
  • Leave the owner a copy. A baseline the owner has seen and signed is far stronger than one they've never seen.

Standards and sources

Checked against these sources on . Your agency's own manual takes precedence.

Questions

What is included in a pre-construction survey?

A record of the building (stories, construction type, party walls), photos of every elevation and room, and a defect log with the location, type and measured size of every existing crack. Most surveys add a narrated video, a crack map and the owner's signature. The report is shared with the owner and kept until the post-construction survey.

Who does a pre-construction survey?

Usually an engineering, forensic or survey firm hired by the contractor, the developer or their insurer. Some jurisdictions name the qualification: Philadelphia requires a licensed professional engineer for surveys triggered by §4-A-3307. Blasting contractors often use specialist pre-blast survey firms.

How far from the site should properties be surveyed?

It depends on the rule or contract. Philadelphia's trigger includes excavation more than 5 ft below adjacent grade within 10 ft of a building and any work within 90 ft of a historic-register building. For surface coal mining blasts, 30 CFR 816.62 covers dwellings within 1/2 mile of the permit area. Otherwise the engineer sets the radius from the expected vibration and ground movement.

How do you measure crack width?

With a crack width gauge or comparator card held across the crack at its widest point, read in millimeters. Take a close-up photo with the gauge readable in frame and a wide photo showing where the crack is. Where movement must be tracked during the works, install a tell-tale and record its baseline reading.

Can a homeowner refuse a pre-construction survey?

Yes, access to private property needs the owner's consent. Record the refusal in writing, with the date and who refused, and survey what you can from the public right-of-way. That record matters if the owner later claims damage.

What is the difference between a pre-construction survey and a post-construction survey?

The pre-construction survey is the baseline before the works. The post-construction survey repeats it after the works, following the same rooms and crack IDs, so new or wider cracks can be told apart from existing ones. Without the first, the second has nothing to compare against.

Do this inspection on your phone: AI drafts it, you approve

Inspectial turns the photos, voice notes and GPS from this checklist into a structured, map-ready inspection record. Every finding links to its photo, and nothing is official until you approve it.

An empty room in an older house: a water-stained ceiling with a hole and a long crack, a diagonal crack running up from the head of the left-hand door, a hairline crack below the wall outlet, a vertical crack with lost plaster on the right-hand wall, and missing floorboards in the middle of the floor.
Property AP-041239.9452, -75.1609 · pre-construction pack
  • Ceiling · stainwater stain and hole, approx. 1.5 ftAI suggested
  • Ceiling · cracklong crack along board jointAI suggested
  • North wall · crackdiagonal, 0.5 mm wide, 10 in longHuman verified
